• Capital Reserve Project Update

    December 2025



    Included Projects:

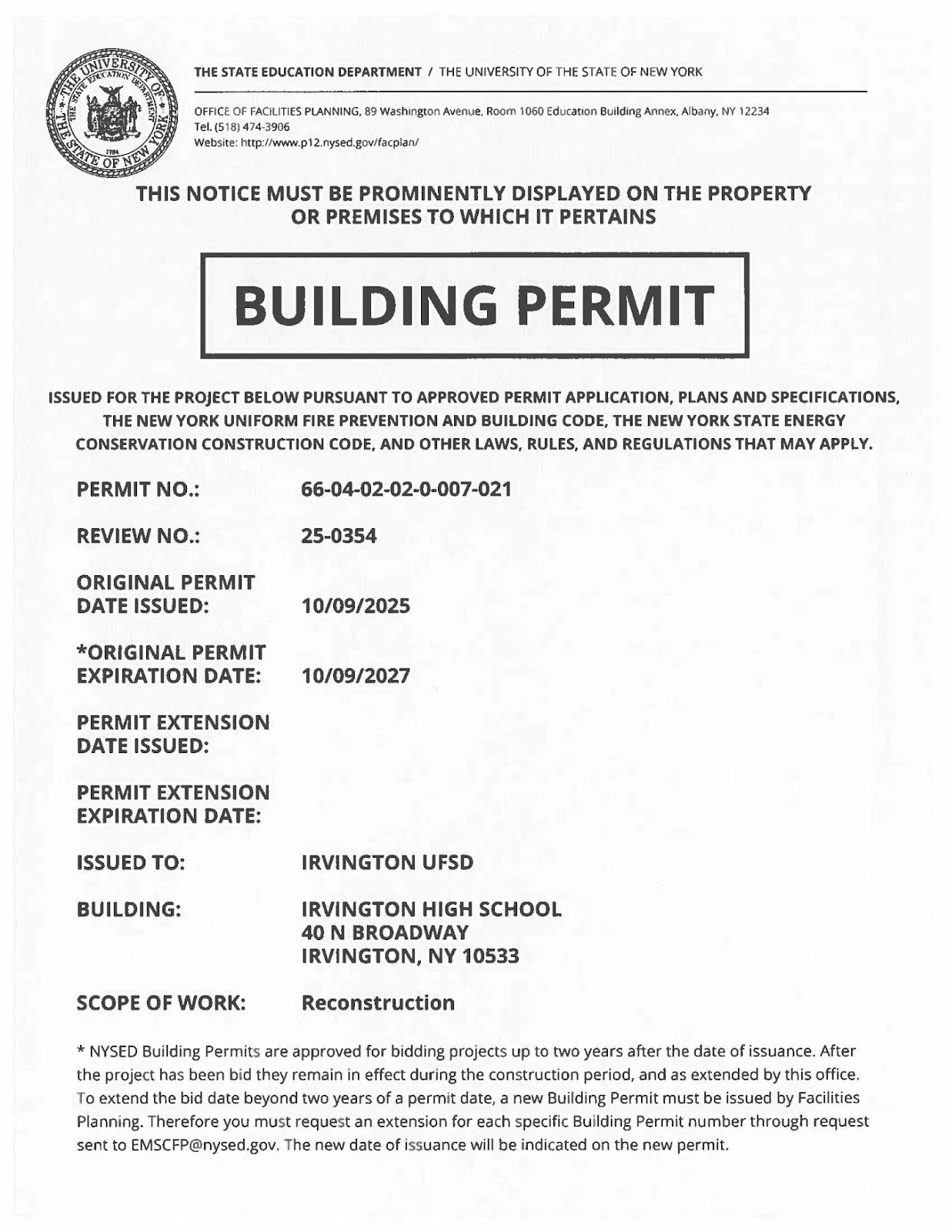

    • Phase 1 - Sed Permit Issued
    • Installation of Field Lighting on Mezaros
    • Replacement of the Turf on Mezaros
    • Resurfacing of the Oley Track
    • Removal of Casework in some High School Classrooms
    • Replacement of some Ground Floor Windows at the Middle School for Safety Reasons
    • Bathroom Upgrade of the First Floor Girls Bathroom in the High School
    • Phase 2
    • Paving of the Basketball Court on the Dows Lane Campus
    • Paving of the Play Area at Dows Lane on the East Side of the Building

    Bids:

    • Electrical Bid to Support Field Lighting Project Received November 19 and to Be Awarded December 2
    • Bid Specifications for the Remaining Phase 1 Projects Are Currently Being Finalized

    Timeline Updates:

    • Weather Permitting, Field Lights Installation to Be Completed by March 15, 2026
    • Track and Field Replacements Work to Begin in June 2026 After Spring Season Is Complete
    • Remaining Phase 1 Work to Be Completed Summer 2026
